Pump Reliability: 4 Pillars for Stable ANSI Pump Performance

Reliable ANSI pump service depends on four connected areas: correct hydraulic duty, sound installation, condition evidence, and documented supply quality. The framework below is designed for a recurring-failure review or a replacement decision. It helps identify the next corrective action without assuming that the last failed component was the root cause.

Reliability review of an ANSI process pump using duty, installation, maintenance and quality data
Engineering source review Replacement-data workflow Updated Aug 29, 2026
In This Guide
  1. Pillar 1: Hydraulic duty
  2. Pillar 2: Installation and alignment
  3. Pillar 3: Condition evidence
  4. Pillar 4: Supply quality and traceability
  5. Four-pillar decision table
  6. Reliability topic map
  7. Recurring failure? Send the pattern, not just the failed part.
  8. Need a reliability review before the next repair?
  9. FAQ

Reliability starts with context

A component failure is an observation, not a complete diagnosis. Connect the failed part to the pump’s duty, operating point, installation, condition trend, maintenance history, and material or fitment evidence before selecting the next repair.

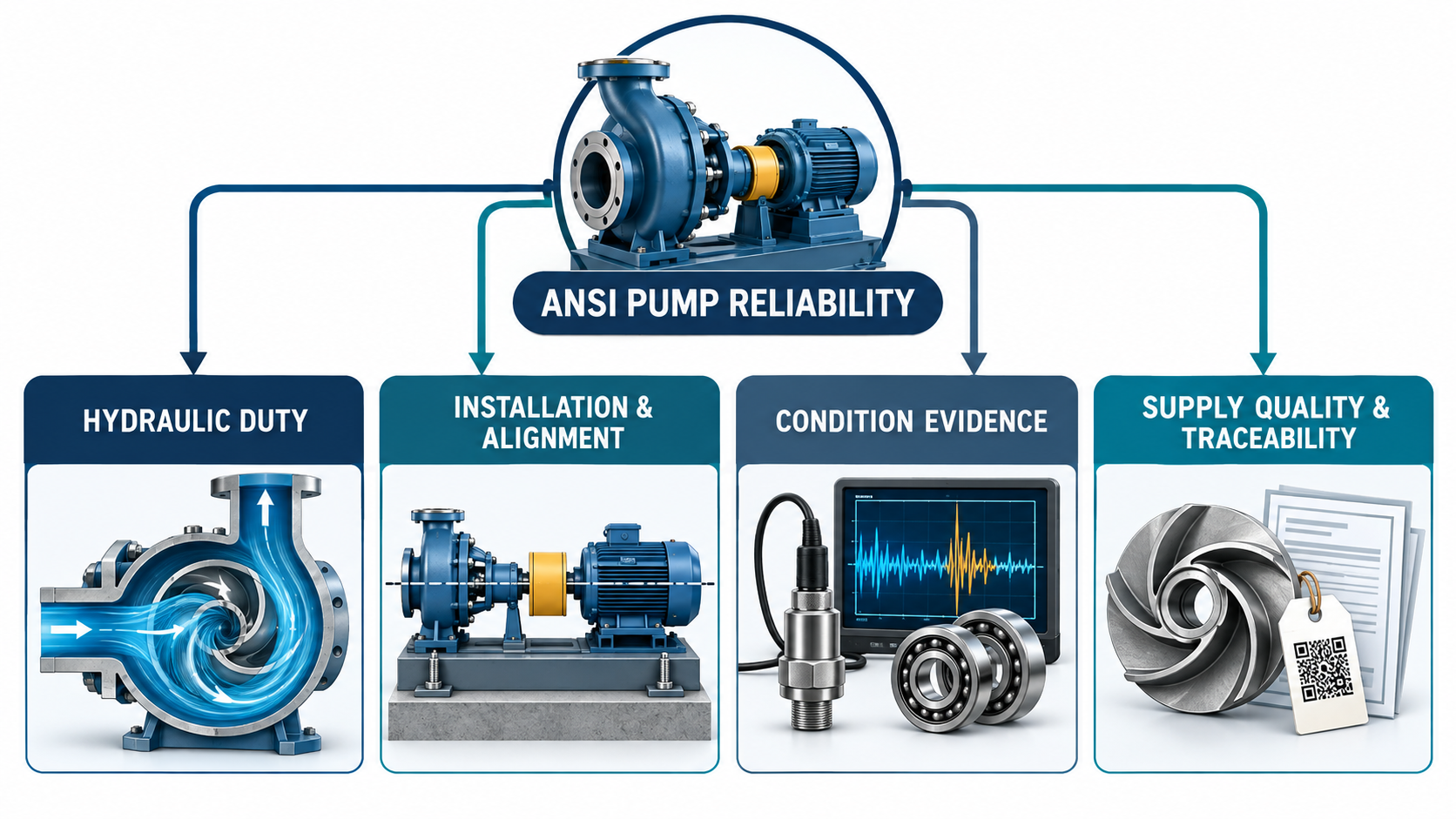

Pillar 1: Hydraulic duty

The pump must operate within a suitable hydraulic and process envelope. Check measured flow and head against the applicable pump curve and system condition. Review minimum flow, NPSH, power, speed, operating region, fluid properties, control state, and any change in the process or piping.

  • Normal, minimum, and maximum flow and head.
  • Measured suction and discharge pressure, speed, liquid temperature, density, viscosity, vapor pressure, solids, and gas.
  • Pump curve, system curve, operating point, and manufacturer/project POR or AOR limits.
  • NPSHa versus NPSHr and the current project margin basis.
  • Valve, bypass, parallel-pump, VFD, and sequencing behavior.

Use the pump system fundamentals guide to interpret curve interaction and the hydraulic-loads guide when radial or axial forces are part of the failure question. Hydraulic correction should come before promising a longer bearing or seal life.

Pillar 2: Installation and alignment

Installation conditions can create loads that look like hydraulic failure. Check rotation, base and foundation, soft foot, coupling, shaft alignment, pipe supports, nozzle strain, lubrication, guards, and thermal movement. Where the service requires it, compare cold and hot conditions and document the method used.

  • Confirm the pump and driver are aligned after the piping is connected.
  • Check whether tightening pipework changes the shaft or coupling condition.
  • Record baseplate, grout, anchor, foundation, and looseness observations.
  • Verify coupling fit, lubrication, guard clearance, and rotation.
  • Use the actual operating condition when investigating thermal movement or vibration.

If the symptom is a seal leak, inspect the seal chamber, sleeve, shaft runout, flush or barrier, and relative movement. If it is a bearing problem, include lubrication, fit, contamination, electrical current, alignment, and load history rather than presuming thrust.

Pillar 3: Condition evidence

Condition monitoring is most useful when it is tied to operating state and trend. A single vibration number or temperature reading is less informative than repeatable data with location, direction, speed, load, and process condition.

Evidence What it can show Record with it
Vibration Change in mechanical or hydraulic response Location, direction, speed, phase/spectrum and process state
Bearing temperature Thermal trend or lubrication/load change Sensor location, ambient, lubricant and operating point
Seal leakage Face, shaft, flush, pressure or movement issue Rate/pattern, temperature, pressure, seal arrangement and photos
Performance trend Wear, fouling, control or system change Flow, head, speed, power, liquid and valve state
Maintenance history Repeat pattern and consequence Failure mode, date, parts, work scope and downtime

Trend data should be interpreted with the manufacturer’s limits, project requirements, and competent condition-monitoring practice. The ANSI pump vibration guide and the condition-monitoring plan can support the evidence-gathering stage.

Pillar 4: Supply quality and traceability

Quality evidence should match the component and the project requirement. Depending on the component, project, and order, documentation may include material certificates or heat-number traceability, dimensional inspection, PMI, balance records, hydrostatic test records, photographs, and third-party inspection. Do not describe a fixed certificate package as universal unless the order actually requires and supplies it.

  • Confirm the model, size, frame or group, drawing revision, and component scope.
  • Trace pressure-containing parts to material and casting or heat records where required.
  • Verify critical dimensions, fits, clearances, balance, runout, and surface condition.
  • Match seal, shaft, sleeve, wear-ring, bearing, and power-end details to the actual pump configuration.
  • Record deviations, repair dispositions, test scope, witness status, and final approval.

For cross-brand or aftermarket replacement, separate dimensional, mechanical, hydraulic, material, and operating compatibility. The ANSI B73.1 compatibility guide explains why a standard interface does not prove every internal component will fit or perform identically.

Four-pillar decision table

Pillar Evidence Red flag Next action
Hydraulic duty Curve, measured duty, NPSH, speed and liquid Off-design operation or unexplained power/flow change Confirm system condition and operating envelope
Installation Alignment, pipe strain, base, coupling and lubrication Repeatable vibration after piping or maintenance work Inspect external load path before replacing parts
Condition evidence Trend of vibration, temperature, leakage and performance Rising trend or failure linked to a duty state Define inspection and monitoring points
Supply quality Drawings, materials, dimensions, tests and deviations Unidentified parts or missing acceptance evidence Close documentation and fitment gaps before release

Reliability topic map

For broader industry context, review the Hydraulic Institute pump FAQs and resources. Use authoritative guidance to frame the investigation, then apply the actual pump, project, and operating evidence.

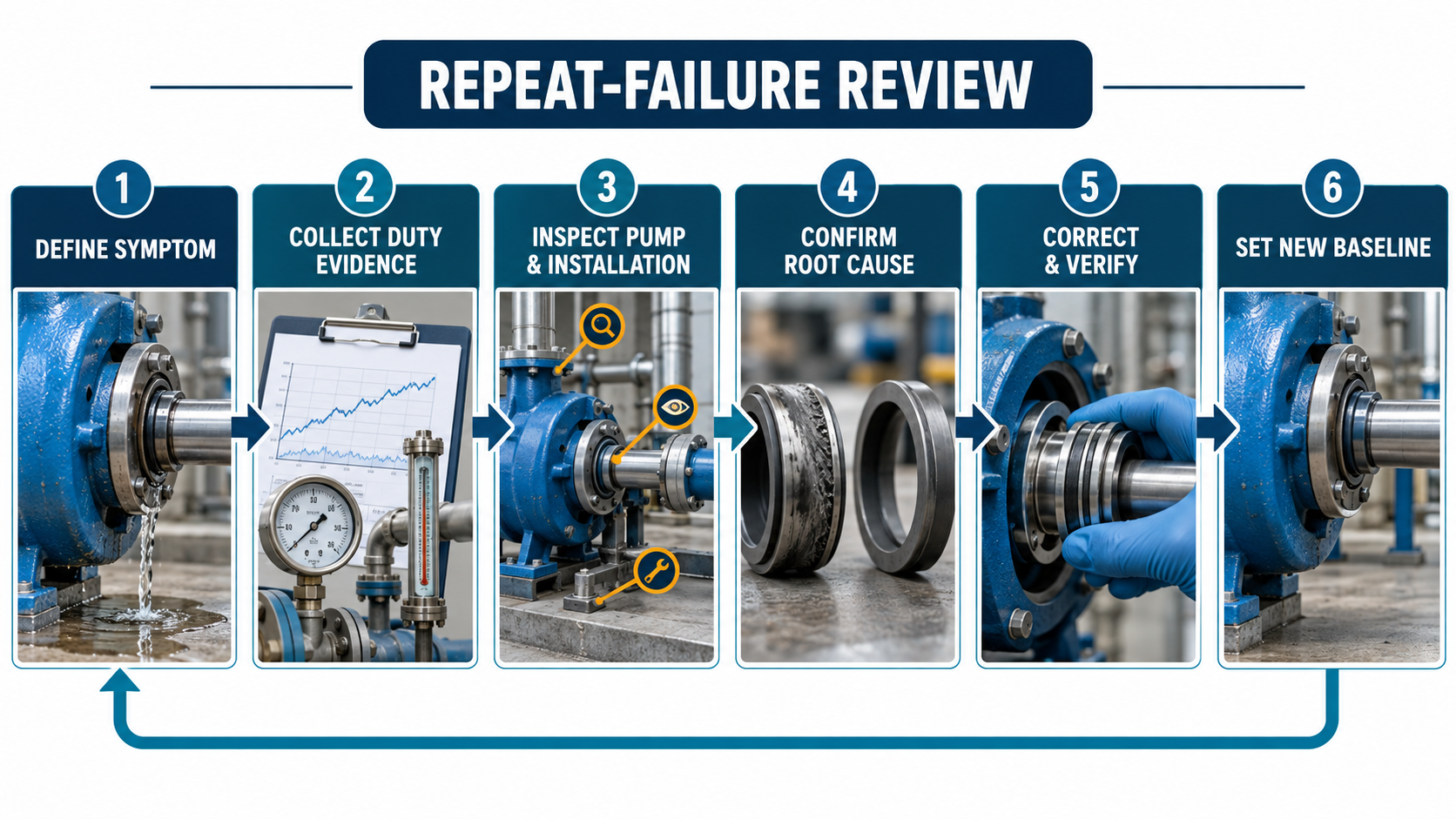

Recurring failure? Send the pattern, not just the failed part.

Share the duty, failure history, photographs, vibration and temperature evidence, alignment and pipe-strain records, model and size, seal arrangement, material details, and any test or inspection documents. A pattern across failures is often more useful than a single damaged component.

Need a reliability review before the next repair?

ANSI Pumps Pro can help organize the hydraulic, installation, condition, material, and fitment questions that remain open. Final corrective action should follow the actual evidence and project requirements.

Request a technical reliability review

FAQ

What are the four pillars of pump reliability?

The four pillars are suitable hydraulic duty, sound installation and alignment, condition evidence and monitoring, and supply quality with traceable fitment and inspection records.

Does a failed pump component identify the root cause?

No. The failed part is evidence. Root-cause review should include duty, operating point, installation, condition trends, maintenance history, materials, and fitment.

What should be monitored on an ANSI centrifugal pump?

Monitor relevant flow, head, speed, power, vibration, bearing temperature, seal leakage, lubrication, alarms, and maintenance trends, always recording the operating condition.

What quality records may be requested for replacement pump parts?

Depending on the component, project, and order, records may include drawings, material or heat traceability, dimensional inspection, PMI, balance, hydrostatic testing, photographs, and deviation or third-party inspection records.

How should recurring pump failures be investigated?

Compare the failure pattern with duty, operating point, installation, condition evidence, materials, seal/support systems, and part fitment. Correct the supported cause before repeating the same replacement.

Have a pump, part number or drawing to review?

Send the installed model, operating duty and available evidence. We will identify the dimensions, materials and interfaces that must be confirmed before quotation.
