What the assessment should answer
Which pump system is being assessed, what process outcome must it deliver, what is happening under real operating conditions, which losses or failure risks are supported by evidence, and what should be investigated or implemented next?

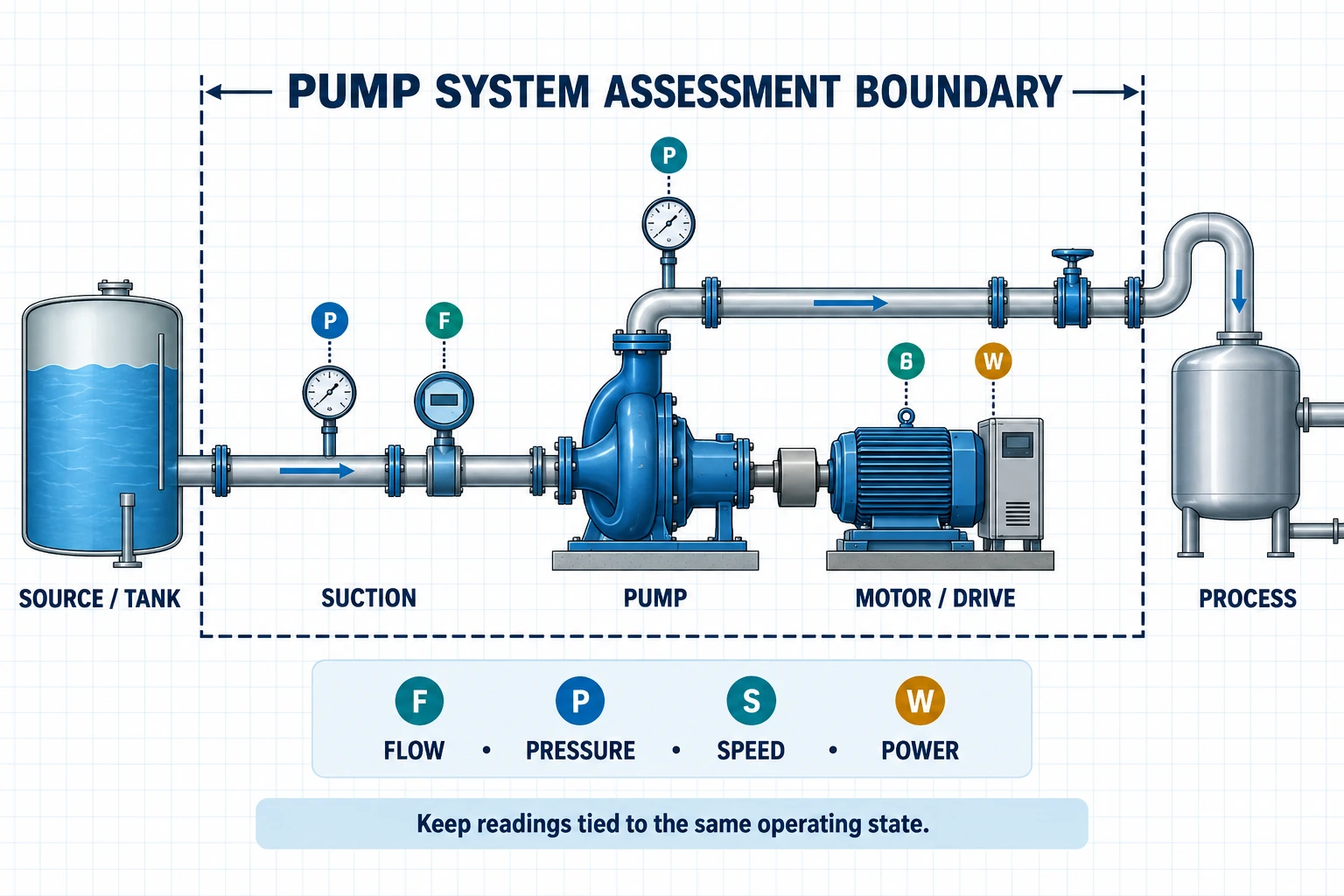

Define the assessment boundary and objective
Start by writing down what is inside and outside the assessment. The boundary may be one pump, a pump-and-motor train, a pair of parallel pumps, a complete process loop, or a group of systems with a common operating problem. A clear boundary prevents a report from mixing readings that belong to different duties.
- Energy objective: understand power use, throttling, bypass, avoidable head, or changing demand.
- Reliability objective: explain repeated seal, bearing, coupling, cavitation, or vibration events.
- Capacity objective: determine whether the installed system can meet a new or changed duty.
- Control objective: understand cycling, unstable pressure, valve behavior, VFD operation, or parallel-pump sequencing.
Record the production state, expected duty, operating schedule, criticality, spare capacity, and any safety or environmental constraints. A pump system assessment should serve a decision, not become a measurement exercise without an owner.
Build a measured baseline
Use the same units, instrument locations, and process conditions when comparing readings. Identify whether each value is measured, taken from a control system, calculated, or estimated. Record instrument range, calibration status, sampling interval, and the production state at the time of measurement.
| Baseline item | Record | Confidence note |
|---|---|---|
| Flow | Value, unit, meter location and method | Stable / fluctuating / estimated |
| Suction and discharge pressure | Gauge location, reference elevation and units | Gauge ID and calibration status |
| Speed and control state | RPM or frequency, valve/bypass position | Command versus actual where relevant |
| Motor input or shaft power | Electrical readings and power factor if available | Meter method and load state |
| Liquid and temperature | Composition, density, viscosity, vapor pressure if known | Process sample or operating record |
| Condition evidence | Vibration, bearing temperature, leakage and alarms | Location, direction and trend |
| Maintenance and production | Failure history, work orders, downtime and duty changes | Period covered and data source |
For variable systems, one snapshot can be misleading. Log representative states or use historian data long enough to characterize the demand profile. The Hydraulic Institute describes assessment levels that range from qualitative review to quantitative work with extended measurement; select the level that matches the variability and consequence of the system rather than applying one fixed method to every pump.
Identify assessment red flags
Red flags are prompts for investigation, not proof of a particular fix. Compare field evidence with the pump curve, system curve, operating region, maintenance history, and process requirements.
- Heavy throttling or a continuously open bypass.
- Repeated seal, bearing, coupling, or wear-component work.
- Unstable flow or pressure, frequent cycling, or unexplained alarms.
- Duty well away from the expected operating region.
- A pump or motor that appears materially larger than the measured requirement.
- Increasing input power, vibration, temperature, or leakage without a documented process change.
- Recurring suction or cavitation symptoms, especially during hot, low-level, or high-flow conditions.
- Parallel pumps that do not share load as expected.

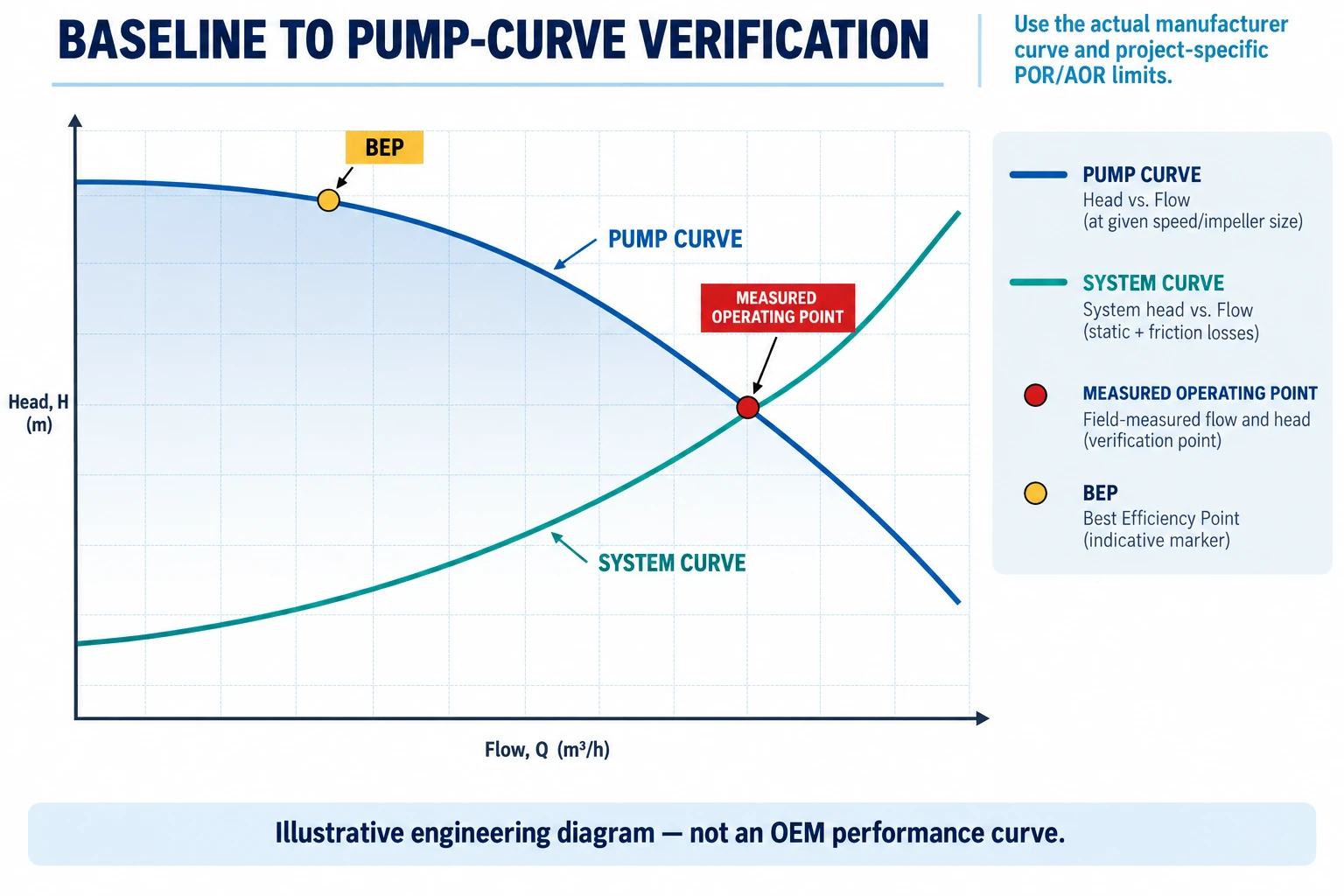

Use the pump system fundamentals guide to interpret curve interaction, operating point, NPSH, and controls. Where the question is hydraulic, check measured head and flow before assigning blame to the pump or motor.
Prioritize opportunities with a decision score
Do not rank opportunities by energy alone. A smaller energy opportunity may deserve attention first if it carries a large production or environmental consequence. Conversely, a theoretically attractive change may be premature when the data confidence is low or a shutdown is required.
| Factor | Low | Medium | High |
|---|---|---|---|
| Energy opportunity | Little measured excess power | Some avoidable head or runtime | Material measured opportunity |
| Reliability exposure | No recurring pattern | Intermittent or localized issue | Repeated failure or severe condition trend |
| Production consequence | Standby or low criticality | Reduced rate or manageable outage | Single point of failure or major loss |
| Implementation cost | Simple operating correction | Maintenance or minor modification | Capital project or extensive redesign |
| Shutdown requirement | No planned outage | Short coordinated outage | Major outage or tie-in |
| Data confidence | Estimated or incomplete | Partly measured | Repeatable, traceable readings |
Assign a transparent score or ranking, then document why an opportunity is high priority. The score is a decision aid, not a fabricated return-on-investment calculation. If energy cost, downtime cost, maintenance cost, or production value are used, show the source period and assumptions.
What a useful assessment report should contain
A report should allow another engineer to understand what was measured, reproduce the logic, and challenge the recommendation. Include:
- Executive summary and decision requested.
- Facility, system, equipment, and assessment boundary.
- Process objective, duty states, and operating schedule.
- Measurement method, instrument information, data quality, and assumptions.
- Baseline flow, pressure, speed, power, condition, maintenance, and production evidence.
- Pump curve, system interpretation, control behavior, and identified deficiencies.
- Opportunity register with evidence, consequence, next step, estimated effort, and confidence.
- Information still needed before design or procurement.
- Recommended implementation owner and verification approach.
- Raw data appendices, photographs, drawings, and revision history.
For energy-assessment work, Hydraulic Institute’s pump system assessment guidance is a useful reference for prescreening, team formation, measurement, analysis, and reporting. Its framework also emphasizes that implementation and measurement and verification follow the assessment; this article intentionally stops at the ranked recommendation.
Assessment vs. optimization
Assessment answers: “What is happening, how confident are we, and which opportunity deserves attention?” Optimization answers: “Which change will we implement, how will we control risk, and did the measured result meet the acceptance basis?” Keep those decisions connected but distinct.
After prioritization, pass the selected opportunity to the pump system optimization execution guide. For a variable-speed option, review the VFD pitfalls and commissioning checks. The pump calculators can organize preliminary head, NPSH, pipe-loss, speed, and power calculations, but the final assessment still depends on project data and the applicable pump curve.
Standards context
ISO/ASME 14414 may be an applicable framework for pump-system energy assessment where the project invokes it. Do not describe this article or a site review as “compliant” with that standard by default. The assessment scope, measurement quality, calculations, reporting, and verification basis should follow the current purchased standard, project specification, and qualified assessor’s procedure.
Send your baseline data for an assessment review
Share flow, suction and discharge pressure, speed, liquid, valve or bypass condition, motor or power readings, operating hours, pump curve, and maintenance history. We can help identify missing evidence and separate an assessment question from an implementation decision.
FAQ
What is a pump system assessment?
It is a structured review of a pumping system using its process objective, measured duty, energy or condition evidence, operating history, and system constraints to identify and rank improvement opportunities.
What data is needed for a pump system assessment?
Typical inputs include flow, suction and discharge pressure, speed, motor or power readings, liquid and temperature data, control positions, pump curves, operating hours, maintenance history, and production conditions.
How do I rank pump optimization opportunities?
Rank them using measured opportunity, reliability and production consequence, implementation effort, shutdown requirement, and data confidence. State assumptions and avoid presenting an unverified ROI as a fact.
Is a pump assessment the same as pump optimization?
No. Assessment diagnoses and prioritizes. Optimization selects and implements an intervention, then verifies the result against a defined baseline and acceptance basis.
Engineering note: Field measurements should be taken by competent personnel using suitable instruments and safe work practices. Final recommendations must account for the actual process, equipment limits, and project requirements.
