Goulds 3196 vs Durco Mark III: Engineering Replacement Comparison
Use this page to decide what must actually be compared before a complete-pump, wet-end or part-level replacement is specified. A common ANSI/ASME dimensional framework does not make the two internal architectures universally interchangeable.
What are you actually trying to replace?
The answer changes which interfaces need to be verified and which internal-part assumptions must be avoided.
Compare architecture, not brand slogans.
This matrix is written around purchasing consequences: what must be verified before a replacement decision is released.
| Verification Point | Goulds 3196 | Durco Mark III | Replacement Meaning |
|---|---|---|---|
| Standard context | ANSI/ASME process-pump platform | ANSI/ASME process-pump platform | Common dimensional framework does not prove internal-part interchangeability. |
| Identification system | STX / MTX / LTX / XLT-X 17-in / X-17 configurations require separate verification. | Group I / II / III | Do not convert a Goulds frame directly into a Durco Group without configuration review. |

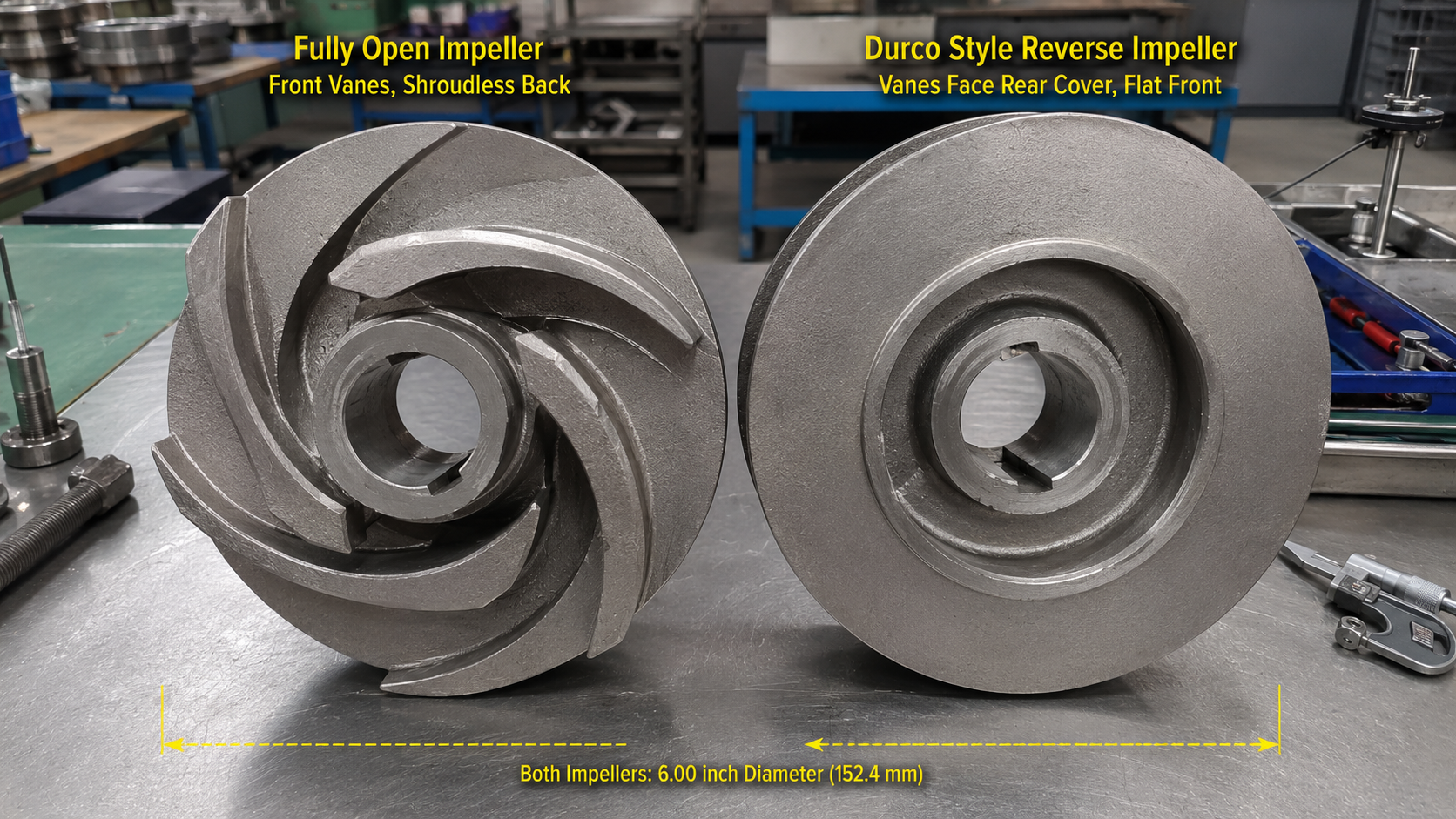

| Impeller architecture | Open-impeller 3196 architecture; verify the exact variant and configuration. | Reverse-vane is a primary Mark III configuration; front-vane/open variants also exist. | Verify impeller style, size/frame or Group, trim and exact reference separately. |
| Adjustment procedure | Follow the applicable 3196 IOM and its specified reference surface. | Follow the applicable Mark III IOM and configuration-specific reference surface. | Do not transfer a clearance value, reference surface or procedure from one platform to the other. |

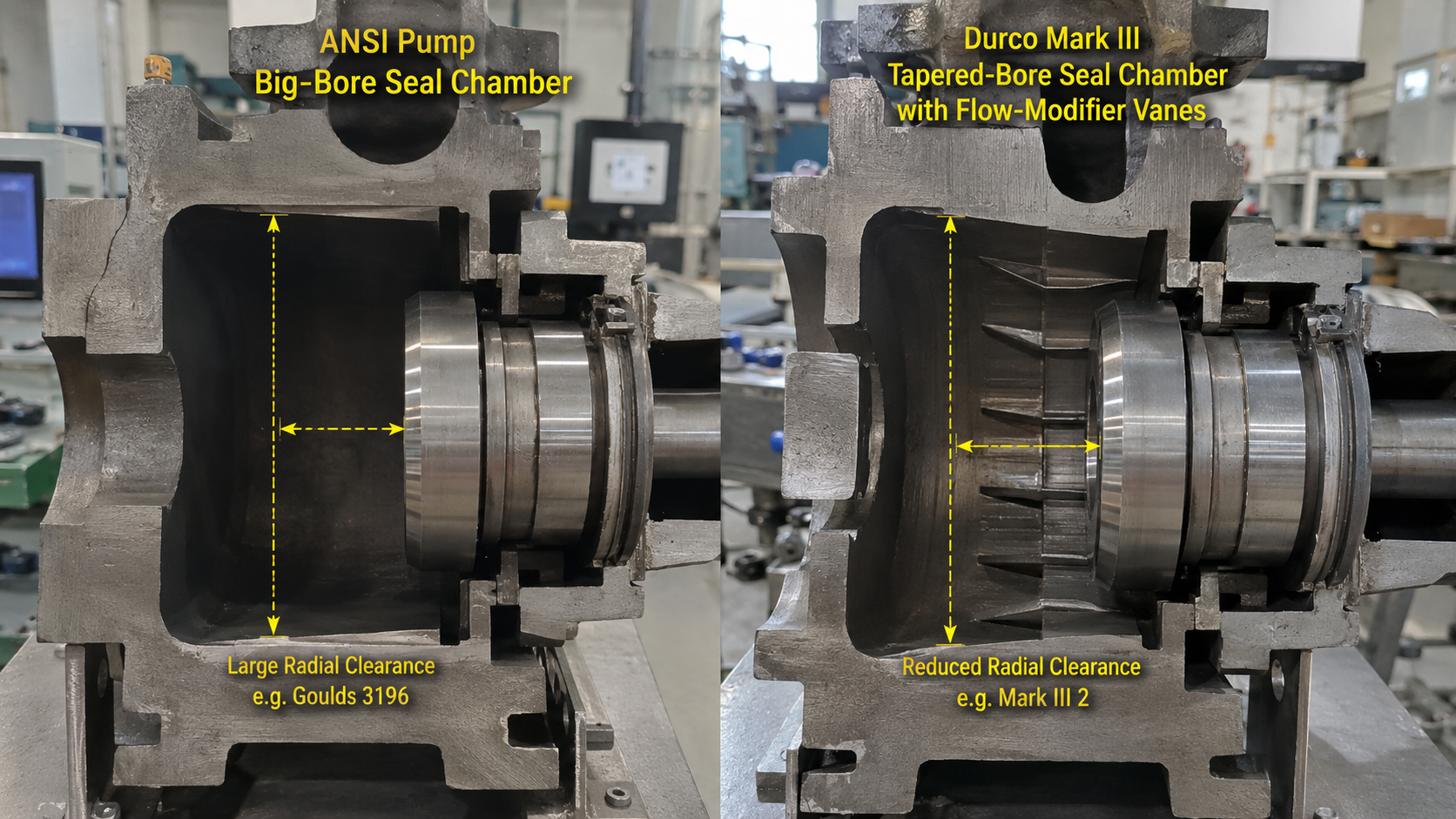

| Rear cover / seal chamber | Configuration-specific | Configuration-specific | Matched interfaces matter for wet-end and seal-area replacement decisions. |
| Internal parts | 3196 family | Mark III family | Not universally interchangeable by ANSI designation alone. |
| Complete pump | Can be evaluated as an engineering replacement project | Review hydraulic, dimensional, material, driver, seal and documentation requirements. | |
Common ANSI framework ≠ common internal architecture.
A simplified visual helps the buyer understand where “dimensional replacement” ends and platform-specific internals begin.
Compare the installed interfaces
Nozzle, base, driver and operating-duty context matter for a complete-pump replacement.
Keep internal platforms separate
Frame/Group, impeller, shaft, cover and seal-area references remain platform-specific unless verified.
Choose the correct downstream route
Part identification, impeller fitment and wet-end supply each have their own verification page.
Use supply timing as a project constraint—not as a substitute for compatibility review.
For projects where the quoted OEM lead time is 16–26 weeks, a verified replacement route may offer a shorter procurement path for shutdown-critical applications. Exact applicability still depends on the requested scope and configuration.
For confirmed stocked configurations, emergency shipment can be arranged in as little as 48 hours after part identity, material and quantity are verified.
Typical complete replacement-pump production lead time: 6–8 weeks, subject to pump configuration, metallurgy, testing and documentation requirements.
Compatibility evidence remains the decision gate before procurement.
Move from comparison to the relevant engineering task.
Find a Part by POS
Identify component function and exact reference context.
Open POS finder →Verify a Reverse-Vane Impeller
Check Group, size, POS 103, trim and reference.
Review impeller fitment →Review Wet-End Supply
Confirm material, configuration and supply route.
Review supply options →
